Site Paving & Concrete Streets

Industrial site paving, access roads, loading zones, and private streets built for heavy equipment and high-traffic operations.

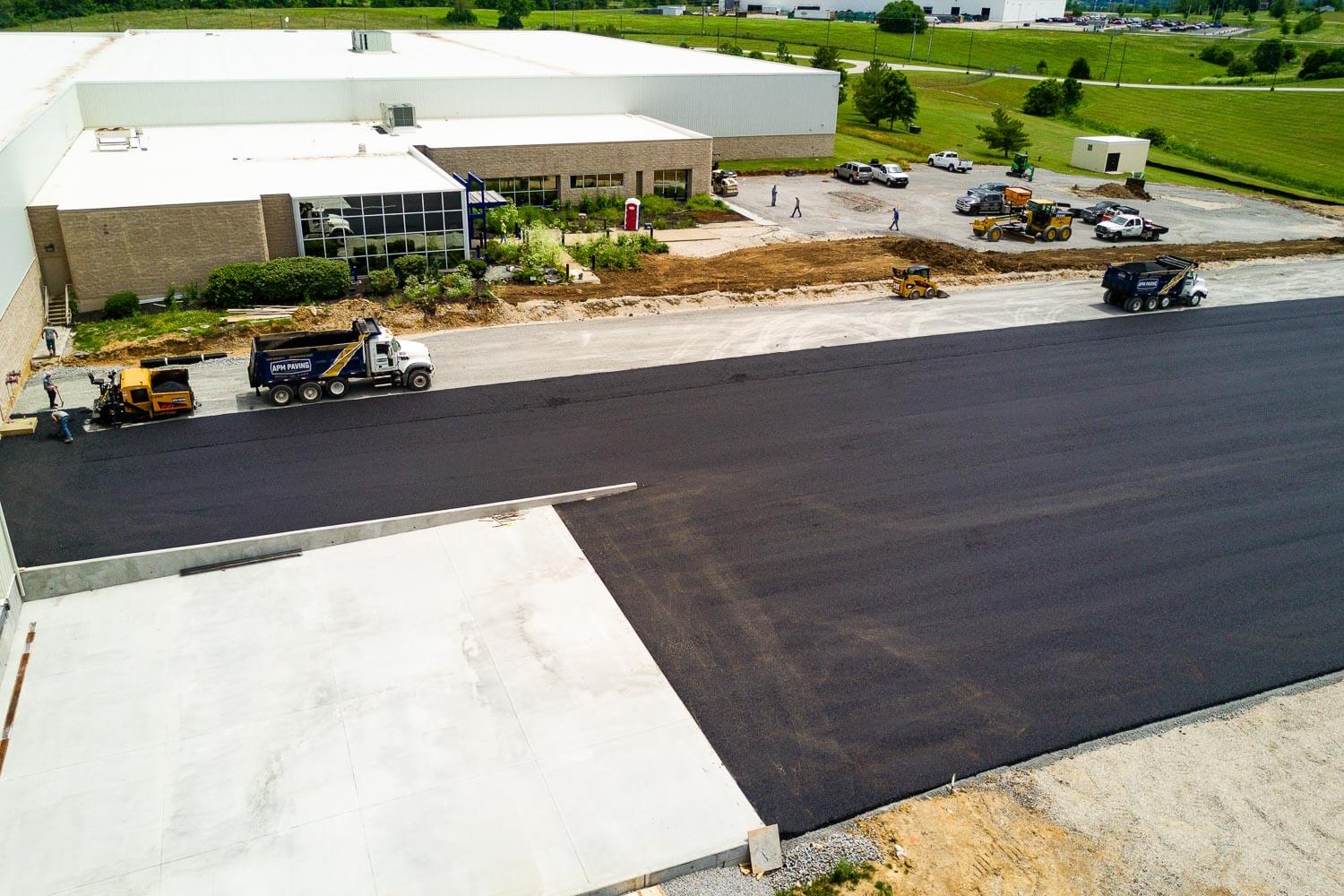

Site paving and concrete street construction represent critical infrastructure for commercial and industrial developments, providing durable access for heavy vehicles, proper site circulation, and reliable load-bearing surfaces for logistics operations. We specialize in commercial site paving, heavy-duty access roads, loading zones, truck courts, private streets, fire lanes, and service drives across Denton and North Texas. Our site paving services encompass everything from industrial park road networks to retail center circulation drives, from logistics center truck yards to manufacturing facility heavy-haul routes. Concrete paving offers significant advantages over asphalt for heavy commercial traffic including 30-40 year lifespan versus 10-15 years for asphalt, superior load capacity for daily heavy truck traffic, excellent performance in Texas heat without rutting or softening, minimal maintenance requirements beyond periodic joint sealing, and lower lifecycle costs despite higher initial investment. We design site paving for specific traffic requirements – delivery truck routes require 8-10 inches of concrete, semi-truck routes need 10-12 inches, and specialized heavy haulers may require 12-14 inches with enhanced reinforcement. Proper base preparation is critical – we excavate unsuitable materials, install properly compacted aggregate base, and ensure adequate subgrade bearing capacity. Our paving includes integrated drainage systems with curbs, gutters, catch basins, and underground storm piping to manage North Texas rainfall events. We coordinate site paving with overall site development including utilities, grading, landscaping, and building construction for seamless project execution.

Applications

Logistics Center Truck Yards
Industrial Park Roads & Streets
Loading Areas & Dock Approaches
Service Roads & Access Drives
Fire Lanes & Emergency Access
Equipment Yards & Staging Areas
Airport Service Roads
Municipal Street Construction

Project Timeline

A 1-mile industrial park road (24-foot width) proceeds through four phases. Phase 1 – Earthwork & Utilities (2-3 weeks): Mass excavation, subgrade preparation, utility coordination and installation (water, sewer, gas, electric, communications buried beneath road), drainage structure installation including catch basins and storm piping, and subgrade compaction and proof-rolling. Utilities are critical path items requiring careful coordination with multiple providers. Phase 2 – Base Preparation (2 weeks): Aggregate base delivery and placement in lifts, compaction of each lift to 95% density, density testing and verification, and fine grading to precise elevations with laser control. Phase 3 – Concrete Paving (3-4 weeks): Edge forms and joint forms installation, reinforcement placement per engineering, concrete placement in sections (typically 500-1,000 linear feet per day), finishing and jointing, and sawcutting control joints. We typically pave one lane width at a time for wide roads. Phase 4 – Curbs, Gutters & Striping (1-2 weeks): Curb and gutter installation, final catch basin adjustment and grating, striping and pavement marking, and final cleanup. Total timeline: 8-12 weeks for complete 1-mile road from clearing to final striping. Large projects with multiple miles may extend proportionally. Weather delays are common in North Texas, particularly spring rains. Coordination with utilities adds complexity and potential delays – advance coordination is critical.

Technical Specifications

Thickness: 8-10" delivery routes, 10-12" semi truck routes, 12-14" heavy haul
Concrete strength: 4,000-5,000 PSI
Base: 6-8" compacted aggregate base (95% modified Proctor)
Subgrade: Compacted to 95%, proof-rolled
Reinforcement: #4 rebar on 18" grid or fiber reinforcement
Joints: Contraction joints 12-15 feet, expansion joints 50-75 feet
Crown/slope: 2% for drainage
Curb and gutter: Integral or separate pour
Dowel bars: 18" long at expansion joints for load transfer
Finish: Broom or tine finish for traction

Denton Area Considerations

Texas heat significantly impacts concrete paving construction and performance. Summer temperatures exceeding 100°F require hot weather concrete practices including cooled mixing water, retarding admixtures for extended workability, fog spraying during finishing operations, and curing compounds applied immediately. The heat actually accelerates strength development, allowing earlier traffic in some cases. However, asphalt suffers in extreme heat with softening, rutting, and bleeding – making concrete the superior choice for Texas applications. North Texas experiences heavy rainfall events requiring robust drainage design – 4-6 inch rain events can occur, necessitating adequate storm system capacity and detention/retention facilities. Denton's expansive clay soils require proper subgrade treatment and may dictate thicker base course, geotextile reinforcement, or soil stabilization. Utility coordination is critical in Denton area with Denton Municipal Electric, Atmos Energy, Texas Water, Frontier Communications, Spectrum, and AT&T all having infrastructure that must be coordinated. City of Denton and Denton County have specific requirements for street construction including width standards, pavement sections, drainage design, and utility separation. For roads to be dedicated to public entities, TxDOT specifications and local amendments apply. Traffic management during construction requires coordination with local authorities for any work affecting public right-of-way. The I-35E corridor development creates high demand for industrial site infrastructure.

Frequently Asked Questions

Featured Projects

Denton Industrial Park - 2 Miles of Concrete Roads

We constructed the complete road network for a new 400-acre industrial park development, creating the primary infrastructure serving 15+ future buildings totaling 3 million square feet. The scope included 2 miles of main collector roads (28-foot width, 12-inch thickness for heavy trucks), 1.5 miles of secondary access roads (24-foot width, 10-inch thickness), complete underground storm drainage system with 45 catch basins and 6,000 feet of RCP piping, detention pond coordination for stormwater management, and coordination with 8 utility providers installing water, sewer, gas, electric, fiber, and communications infrastructure. The project was complicated by the need to construct roads in phases as the development progressed, maintaining access for construction traffic while protecting completed pavements, coordinating with multiple building contractors active simultaneously, and meeting aggressive timeline for first building occupancy. We installed all utilities beneath roads before paving to avoid future cuts, constructed base course and subgrade in dry conditions to ensure proper compaction, and used laser-guided grading for precise elevations. The roads handle daily heavy truck traffic from multiple industrial tenants including logistics, manufacturing, and distribution operations.

Results:

Completed on schedule despite complex utility coordination. Roads handling heavy traffic perfectly after 3 years.

Logistics Center Truck Court - 100,000 SF

This extreme-duty paving project created a truck maneuvering and staging area for a major logistics center handling 300+ daily semi-truck trips. Requirements included 12-inch thickness concrete designed for continuous heavy truck traffic, 5,000 PSI concrete with enhanced durability, specialized design for tight turning radii where trucks maneuver at slow speeds under full load, integrated loading dock approaches for 82 dock doors, and comprehensive drainage system preventing any standing water. The truck court sees extreme stress – loaded 80,000-pound trucks constantly accelerating, braking, and turning. We specified heavy reinforcement (#5 rebar on 15" spacing), enhanced base preparation with proof-rolling and density testing, dowel bars at all expansion joints for load transfer, and quality concrete mixes from qualified suppliers. The reinforcement pattern was adjusted in turning areas to resist the rotational stress from trucks pivoting. Drainage was critical – we installed 15 catch basins with frequent spacing to eliminate ponding that could create ice in winter. The finishing used deep broom texture for maximum traction.

Results:

Zero cracking or failure after 5 years of heavy use. Client estimates saved $200k vs asphalt + maintenance.
